United Arab Emirates · Abu Dhabi Representative

Petroleum Storage Tank Lining · Abu Dhabi

40m diameter petroleum tank interior lining. Polyurea with NSF-compliant formulation. Return to service in 18 hours.

Petroleum Storage Tank Lining · Abu Dhabi

Customer Type

Petroleum Storage Operator

Industry

Petroleum / Oil & Gas

Project Scale

40m × 12m (~1,400 m²)

Duration

4 days

The Challenge

Aging petroleum tank developed interior corrosion. Traditional epoxy systems require 7-10 day cure — incompatible with operational schedule. Chemical resistance critical: refined petroleum + wash chemicals exposure.

Our Solution

Abrasive blasted to Sa 2.5. Applied 3mm pure polyurea, chemical-resistant grade using JYYJ-H-V8T at 36 MPa with 10-inch PLC. Primer matched to carbon steel substrate. 42°C ambient required gel time tuned to 12 seconds.

What Pioneer Delivered

Not just a machine — a matched system, a trained crew on site, and after-sales backing end to end.

  • An on-site survey of the 40m × 12m tank with dew-point and steel-temperature monitoring before any spray in the 42°C heat — so the lining bonds, not blisters.
  • A single-source system — the JYYJ-H-V8T machine, matched primer and NSF-compliant polyurea tuned and warranted together, not sourced from three suppliers who blame each other.
  • A spray crew trained for confined-space tank geometry and hot-climate application, pre-tuning gel time to 12 seconds at 42°C — the hard part of polyurea is the operator, and we own it.
  • Holiday-tested QA across the full interior and a return-to-service plan built around the operator's schedule — the tank went back to refined petroleum in 18 hours, not 7-10 days.
  • Ongoing remote support for ratio and temperature tuning, plus re-order of the exact matched NSF-compliant material — so the next maintenance cycle is a phone call, not a new project.

Execution Process

  1. 1 · Abrasive Blast to Sa 2.5

    The tank interior is abrasive blasted to Sa 2.5 near-white, stripping corrosion and scale from the carbon steel and cutting an anchor profile. Dust is vacuumed and the surface checked dry before priming in the 42°C ambient.

  2. 2 · Primer & Climate Control

    A primer matched to the carbon steel substrate is applied inside the recoat window for a chemical bond. Dew point and steel temperature are logged, and with 42°C ambient the polyurea gel time is pre-tuned to 12 seconds.

  3. 3 · Polyurea Lining Spray

    3mm of chemical-resistant pure polyurea is hand-sprayed with the JYYJ-H-V8T at 36 MPa, the 10-inch PLC holding ratio and temperature steady across the 40m × 12m shell. The seamless monolithic film covers welds and corners with no pinhole-prone seams.

  4. 4 · Holiday Test & Return to Service

    The cured lining is holiday-detected across the full interior to verify zero pinholes, then the NSF-compliant film is cleared for refined petroleum. The tank returns to service in 18 hours rather than the 7-10 days an epoxy system would need.

Key Technical Highlights

Coating System

3 mm pure polyurea

Chemical-resistant grade, NSF-compliant for refined petroleum contact.

Spray Unit

JYYJ-H-V8T @ 36 MPa

High-pressure plural-component rig with 10-inch PLC precision.

Surface Prep

Sa 2.5 + matched primer

Near-white blast on carbon steel, primed for a chemical bond.

Gel Time Tuning

12 s @ 42°C ambient

Gel time pre-tuned for the hot Abu Dhabi climate to hold build.

Pinhole Defects

Zero (holiday tested)

Full-interior holiday detection verifies a continuous film.

Return to Service

18 hours

Back in service same window vs 7-10 days for an epoxy system.

Project Gallery

On-site application and finished surfaces from this project.

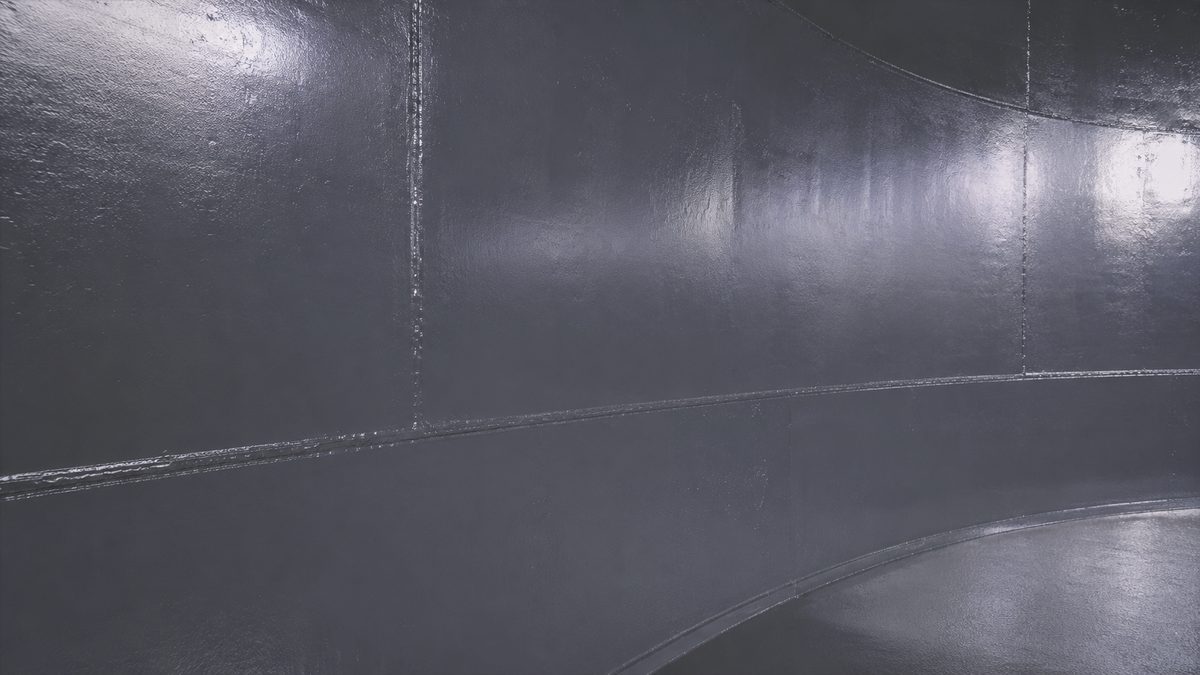

Petroleum Storage Tank Lining · Abu Dhabi — on-site view 1

Project Results

18 hours

Return to service

post-application

20+ years

Service life projection

vs 7-10 for epoxy

Full petroleum spectrum

Chemical resistance

passes ASTM immersion

Zero

Pinhole defects

verified by holiday detection

For Industrial Buyers · Skip the Form

Planning a similar project?

Share your output, voltage, and project scale. Pioneer recommends a matched JYYJ machine + material combination within 24 hours.

✓ ISO 9001 certified plant in China ✓ Reply within 24 hours ✓ TDS · MSDS · COA on request ✓ Mon–Fri 9–18 (UTC+8)

Representative Project: Technical parameters and project outcomes reflect what Pioneer equipment and materials can deliver in similar scenarios. Customer-specific details are held under NDA; full documented case studies available on request.

Get a Quote
