Saudi Arabia · Riyadh Representative

Industrial Facility Flooring Coating · Riyadh

Manufacturing facility 6,000m² floor with polyurea topcoat. Abrasion + chemical resistant high-gloss finish. Production downtime limited to weekend.

Industrial Facility Flooring Coating · Riyadh

Customer Type

Industrial Manufacturing Facility

Industry

Industrial Manufacturing

Project Scale

6,000 m²

Duration

52 hours (weekend)

The Challenge

Active manufacturing plant could only suspend operations 48-60 hours. Existing floor failing under forklift traffic + chemical spills. Required abrasion + chemical resistance with near-zero cure to meet Monday production restart.

Our Solution

Weekend application window. JYYJ-H-V8T at 36 MPa with 2-14 kg/min throughput completed full coverage in 38 hours. Polyurea flooring grade 3mm DFT, primed to concrete. Full cure to forklift traffic in 6 hours post-application.

What Pioneer Delivered

Not just a machine — a matched system, a trained crew on site, and after-sales backing end to end.

  • An on-site slab survey with moisture and dew-point logging before any spray, plus crack and joint routing — so the coating bonded to a sound floor instead of lifting under traffic.
  • A single-source system — JYYJ-H-V8T machine and flooring-grade polyurea matched, tuned and warranted together, not a sprayer, a primer and a coating from three suppliers blaming each other.
  • A spray crew trained for large-area floor work and high-throughput application — the hard part of a seamless 6,000 m² floor is operator pace and overlap control, and we own it.
  • Holiday-tested QA and a schedule built around the plant's 48-60 hour weekend shutdown — the full floor went back to forklift traffic in 6 hours and production restarted on time Monday.
  • Ongoing remote support for ratio and temperature tuning, plus re-order of the exact matched material — so the next bay or a worn zone is a phone call, not a new project.

Execution Process

  1. 1 · Concrete Prep & Shot Blast

    The 6,000 m² slab is shot-blasted to a CSP 3-4 profile to strip old coating, laitance and oil, then cracks and joints are routed and filled so the polyurea lays over a sound, keyed substrate.

  2. 2 · Primer & Moisture Check

    Slab moisture and the weekend dew point are logged, then a concrete-matched epoxy primer is rolled within the recoat window for chemical adhesion across the full floor before the topcoat goes down.

  3. 3 · Polyurea Floor Spray

    Flooring-grade pure polyurea is sprayed to 3 mm DFT with the JYYJ-H-V8T at 36 MPa, sustaining 2-14 kg/min and roughly 6 m²/minute to cover the whole plant inside the weekend window. A seamless high-gloss film leaves no joints for forklift wheels to chip.

  4. 4 · Cure & Monday Restart

    The polyurea is tack-free within minutes and reaches full forklift-traffic cure in 6 hours, leaving margin inside the 48-60 hour shutdown. The floor is holiday-checked for pinholes, then production restarts on schedule Monday morning.

Key Technical Highlights

Coating System

3 mm flooring polyurea

Flooring-grade pure polyurea, seamless high-gloss finish over concrete.

Spray Unit

JYYJ-H-V8T @ 36 MPa

Heated plural-component rig sustaining 2-14 kg/min for large-area work.

Throughput

~6 m²/minute

Sustained spray rate covered 6,000 m² in 38 application hours.

Surface Prep

CSP 3-4 + epoxy primer

Shot-blast profile plus concrete-matched primer for chemical bond.

Abrasion Resistance

Taber H-18

Under 80 mg loss per 1000 cycles, holds up to forklift traffic.

Return to Service

6 hours to forklift

Full cure inside the 48-60 hour window for an on-time Monday restart.

Project Gallery

On-site application and finished surfaces from this project.

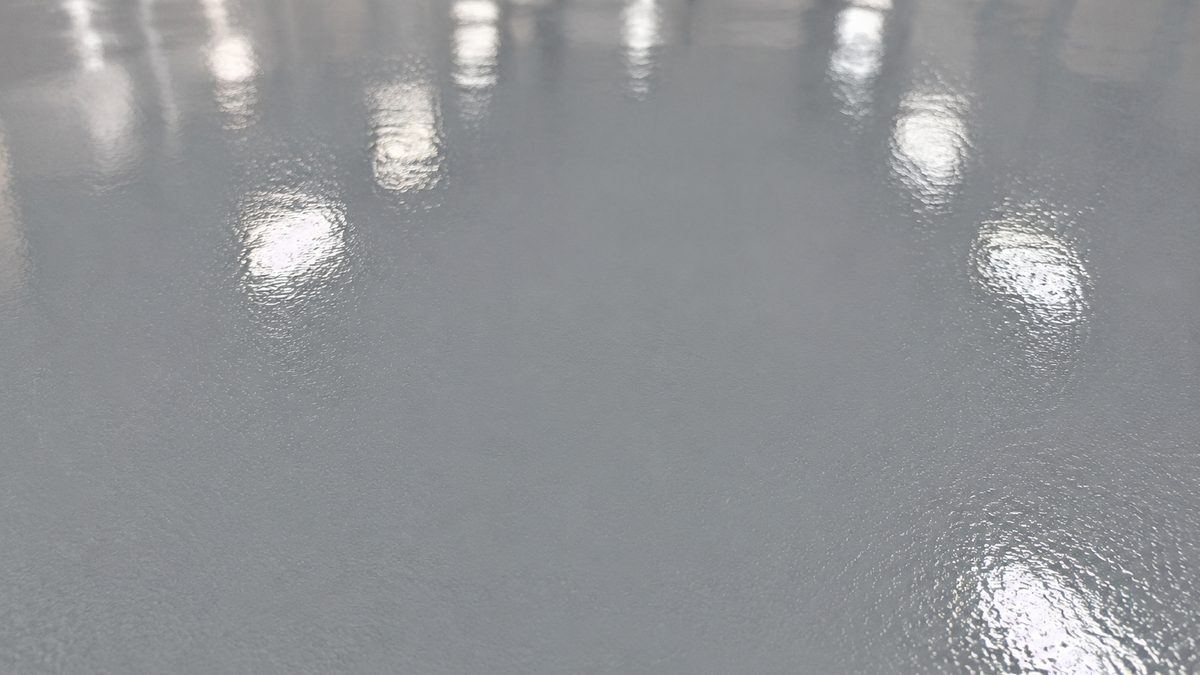

Industrial Facility Flooring Coating · Riyadh — on-site view 1

Project Results

38 hours

Total application time

6 m²/minute sustained

On schedule

Production restart

Monday morning

Taber H-18

Abrasion resistance

<80mg loss/1000 cycles

Full spectrum

Chemical resistance

acids, solvents, alkalis

For Industrial Buyers · Skip the Form

Planning a similar project?

Share your output, voltage, and project scale. Pioneer recommends a matched JYYJ machine + material combination within 24 hours.

✓ ISO 9001 certified plant in China ✓ Reply within 24 hours ✓ TDS · MSDS · COA on request ✓ Mon–Fri 9–18 (UTC+8)

Representative Project: Technical parameters and project outcomes reflect what Pioneer equipment and materials can deliver in similar scenarios. Customer-specific details are held under NDA; full documented case studies available on request.
